Allied Gold Reports Exploration Results at Sadiola Demonstrating Continued Discovery in a World-Class Gold Mineralized System
TORONTO, Oct. 29, 2025 (GLOBE NEWSWIRE) -- Allied Gold Corporation (TSX: AAUC, NYSE: AAUC) (“Allied” or the “Company”) is pleased to provide an update on the ongoing exploration and development activities at its Sadiola Mine in Mali, West Africa, highlighting continued discovery and resource expansion across multiple zones within this world-class gold mineralized system. This is the first of three planned exploration updates, with further releases covering the Company’s Kurmuk Project in Ethiopia and its Côte d’Ivoire assets expected in the coming months, all of which underpin the significant value and optionality in the Company’s portfolio, already characterized by peer-leading mineral inventories and production growth.
2025 Sadiola Exploration Program and Highlights
The Sadiola Mine is a long-life mine undergoing a transformational two-phased expansion plan, the first phase of which is expected to be completed this quarter. Over the longer-term, Sadiola is expected to produce up to 400,000 gold ounces per year at substantially lower costs, well below current costs and industry averages, which is planned to materially contribute to increasing cash flows. With a robust inventory of Mineral Resources and Mineral Reserves supporting increasing production for a long mine life, and with most, if not all mineralized zones open along strike and/or at depth, Allied has undertaken an extensive exploration plan for the following purposes, all of which are expected to create additional value at low finding costs: i) extending mine life likely well beyond the 19 years currently expected from existing Mineral Reserves, ii) increasing operational flexibility and efficiency with the identification and delineation of additional areas of mining, and iii) targeting new mineralized areas that appear to show better grades.
The Company’s five-year exploration goal for Sadiola is to reach over 14 million ounces of Mineral Resources, representing a sequential target of over 3.5 million ounces of new Mineral Resources in addition to the current inventory. The objective includes adding approximately 1.0 million ounces of new oxide, which, in turn, supports Sadiola’s medium-term and long-term expansion strategy, providing upside and optionality as discussed below. Mineral Resources and Mineral Reserves updates are planned to be presented on a yearly basis to document the ongoing mineral inventory buildout program, which is expected to be carried out with similar levels of annual expenditures to the approximately $12 million committed for the current year. Further, as the Phase 1 Expansion at Sadiola allows for the treatment of a higher proportion of abundant, higher-grade fresh ore, the Company expects an increase in the mine’s efficiency and overall performance by concentrating mining operations in fewer, bulkier areas and using new oxide areas as incremental production upside.
Five-Year and Near-Term Exploration Targets
- Sadiola Main: five-year target of 1.5 million ounces of dominantly fresh ore
- Tambali: three-year target of 1.0 million ounces of fresh/oxide ore
- Sekekoto/S12 Trend: two-year target of 0.35+ million ounces of oxide/fresh ore
- FE2 and FE3/4 Trends: three-year target of 0.70+ million ounces of oxide/fresh ore
New Discoveries and Zone Extensions Highlights
Exploration drilling has intersected significant new zones and extensions at Sekekoto West/S12, Tambali, FE2 Trend, and FE3/4 Trend (see Figure 1 for zone locations) with Sekekoto West and the southern part of the FE2 Trend (FE2.5) potentially providing short-term, new and more proximal high-grade oxide resources for the Sadiola mill as mining at Korali Sud winds down. Mineralization remains open along strike and at depth across all four target areas. Highlights include:
- Sekekoto West/S12: 33.0 m @ 15.23 g/t Au (SARC 1699) and 25.0 m @ 11.90 g/t Au (SARC1695)
- Tambali: 12.6 m @ 18.87 g/t Au (SADD181) and 6.7 m @ 8.74 g/t Au (SADD264)
- FE2 Trend: 3.0 m @ 28.19 g/t Au (SARC2318) and 8.0 m @ 6.55 g/t Au (SARC2321)
- FE3/4 Trend: 18.0 m @ 10.68 g/t Au (SARC1957) and 20.0 m @ 5.53 g/t Au (SARC1948)

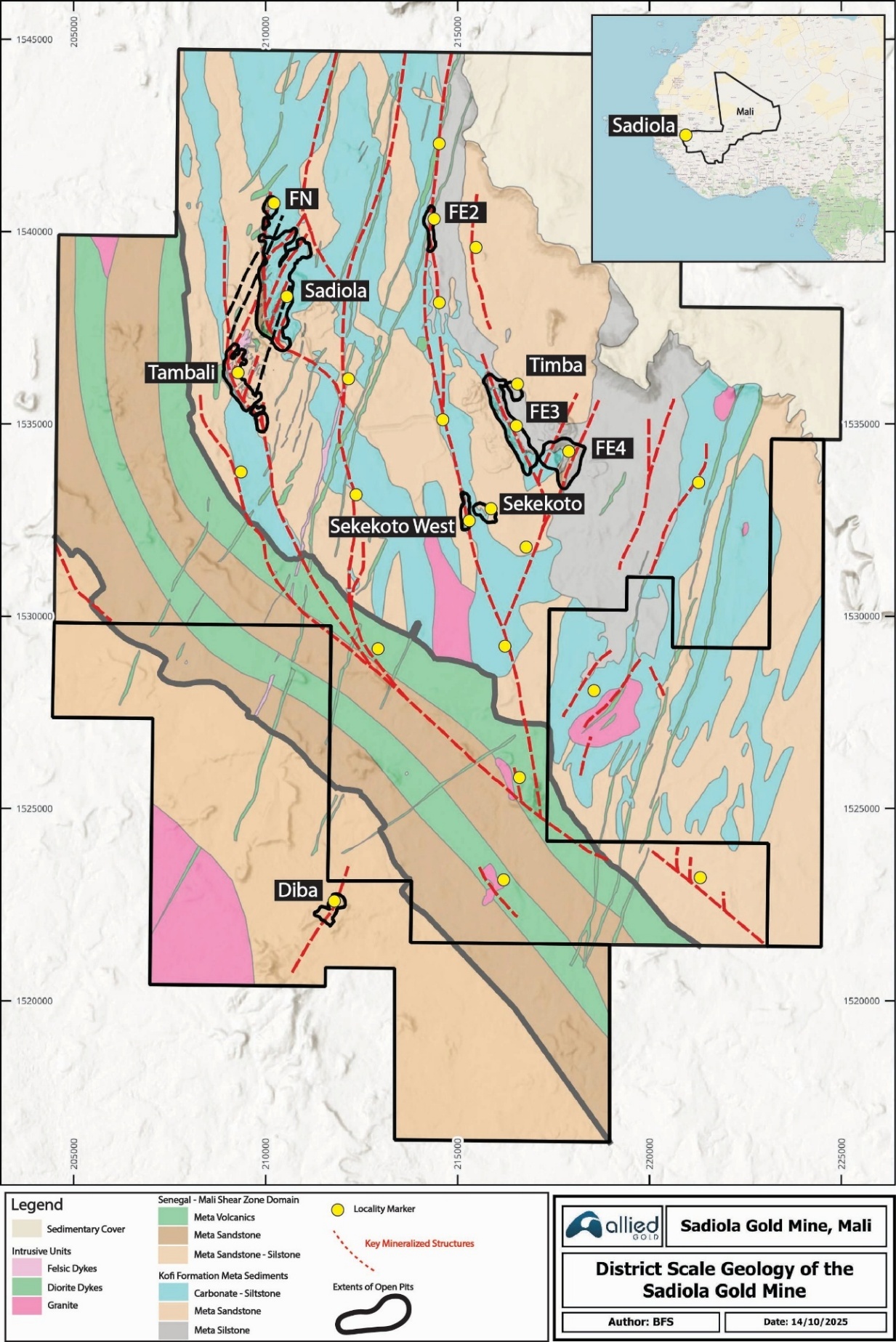

Figure 1: Sadiola Project Plan Map

Exploration Progress Highlights by Zone
Sadiola Main
- This 2,500 m × 200 m deposit remains open down-plunge to the south and at depth beyond 800 m, with excellent potential for underground development
- Drill testing commenced in late Q3 2025 targeting down-plunge and down-dip extensions and additional oxide zones along the western side of the deposit
- See Figure 2 for Sadiola Main Deposit Geology and Drill Plan, and Figure 3 for Sadiola Main Deposit Reference Section
Tambali
- A 2,200 m × 500 m mineralized zone, located 600 m to the west of the Sadiola Main Pit, that remains open to the north, northeast and at depth
- 2025 drilling (44 holes, 12,005 m) intersected multiple fresh rock zones including 12.6 m @ 18.9 g/t Au and 31.2 m @ 2.8 g/t Au
- A drill program targeting high-grade oxide targets is planned for late 2025/early 2026 with updated modelling and resource estimate updates in Q1 2026
- See Figure 4 for Plan view Tambali Geology and Drilling, and Figure 5 for Tambali Type Section
Sekekoto West and S12
- Sekekoto West oxide and fresh mineralization has been traced for 1,400 m along strike and remains open to the north towards S12
- 2025 drilling (91 holes, 9,281 m) intersected grades up to 25.0 m @ 11.9 g/t Au and 41.0 m @ 7.1 g/t Au.
- Geophysical surveys are planned to trace the mineralized contact zone north toward S12 and for another 1,400 m to the north of S12

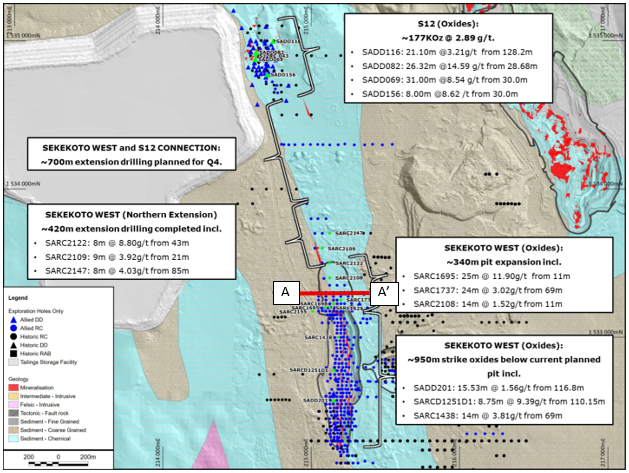

- See Figure 6 for Sekekoto West and Sekekoto Drill Plan and modelled/active pits, and Figure 7 for Type Section Sekekoto West Deposit
FE2 Trend
- Oxide and fresh gold mineralization has been traced continuously for over 3.9 km and remains open to the north and at depth
- 2025 drilling (452 holes, 26,378 m) returned intercepts including 3.0 m @ 28.19 g/t Au and 23.0 m @ 1.92 g/t Au, highlighting ongoing near-surface potential
- Additional drilling planned to extend mineralization to north and infill as necessary. An updated mineral resource is planned for Q1 2026
- See Figure 8 for FE2 Trend Geology and Drill Plan and Figure 9, as a typical section of FE2N
FE3/4 Trend
- Covers a 3.25 km × 1.1 km mineralized corridor with historic production of 1.33 Moz(1)
- Recent intercepts of 18.0 m @ 10.68 g/t Au and 17.0 m @ 4.90 g/t Au confirm the potential for resource expansion down-dip and along NE-trending shears subject to ongoing metallurgical studies
- 80 of a planned 200-hole resource conversion program now completed. Obvious additional places to test, especially along northeast-trending structures

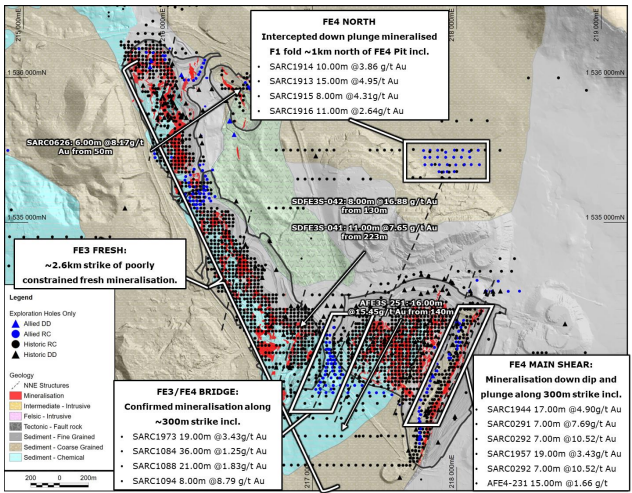

- See Figure 10 for FE3/FE4 Pits, Summary Geology and Drill Plan, Figure 11 for FE4 Pit Grade Dot Plot, Allied Drilling and Section Location, and Figure 12 for Interpreted Geological and Drill Section Through FE4 Pit
Detailed Drill Data
Significant drill intercepts, with a 0.5 g/t Au cut-off, since January 2025, by zone, are available through the following link. Estimated true widths vary from 45% to 90% drilled length with true widths in Sekekoto holes SARC1631, 1632, 1685, 1691 and 1699, are not clear as they were drilled semi-parallel to the zone. A summary of drill hole collars can be found at this link.
Discussion and Next Steps
Since January 1, 2025, Allied Gold’s exploration, comprising 700 holes totaling 60,496 m of drilling (including sterilization drilling), has focused on targeting oxide gold mineralization with a lesser emphasis on fresh-rock-hosted gold mineralization. Significant amounts of oxide and fresh rock gold mineralization have been intersected at the Tambali, Sekekoto/S12 Trend, FE2 Trend and FE4 zones (see Figure 1 for locations). This ongoing work highlights Allied's commitment to creating long-term value through focused and sustained exploration. The next steps of the program are summarized below:
- Continued drilling across FE2 Trend, FE3/4, Sekekoto West/S12, Tambali and Sadiola through Q4 2025 and into 2026 and beyond
- Initiation of IP geophysical surveys along a 2.3 km gap between Sekekoto West and S12 and north of S12 to the boundary of the historic IP survey
- Resource modelling and updated mineral resource estimate for multiple zones expected in Q1 2026
- Ongoing 3D geological modelling integrating magnetic, gravity, and electromagnetic survey data to identify additional blind targets
Strategic and Development Context
Allied Gold’s 2025 exploration program continues to deliver strong results across multiple target areas, providing Sadiola with increased operational flexibility in the short term as well as optionality to leverage its increased sustainable production capacity after completing the Phase 1 Expansion later this year and in preparation for subsequent phases.
The completion of the initial expansion will allow Sadiola to treat up to 60% of fresh rock at a rate of up to 5.7 Mt/y in the modified process plant, allowing the mine to produce within an expected range between 200,000 and 230,000 ounces of gold per year in the medium term, with the higher end of the range driven by the addition of moderate-to-high-grade oxide ore to the plant feed.
The Phase 2 Expansion, currently planned as a new processing plant with capacity of up to 10 Mt/yr of fresh and oxide ore with targeted start production in late 2028, is expected to increase production to an average of 400,000 ounces per year for the first four years and 300,000 ounces per year on average for the mine's life, with AISC(2) expected to decrease to below $1,200 per gold ounce. Further, the Company is conducting engineering studies to determine the optimal path for expansion, including the option of progressively expanding the existing plant after the Phase 1 Expansion, with the aim of achieving similar ultimate production levels at a lower capital intensity. While this progressive expansion would also allow for the treatment of fresh and oxide ore, its installed capacity could be leveraged and maximized with additional oxide ore sources, as well as high-grade transitional ore in the medium to longer-term.
As such, although Sadiola showcases a long mine life underpinned by an impressive inventory of nearly 10 million ounces in Measured and Indicated Mineral Resources(3), and nearly seven million ounces in Mineral Reserves, its exploration strategy can materially improve its production profile, cash flows, optionality and value creation, leveraging its ongoing expansion plan.
Technical Discussion
The Sadiola Mine is a long-life mine that has produced approximately 8.8 million ounces of gold(1) primarily from oxide gold mineralization. Current end of year 2024 Reserves total approximately 7 million ounces of gold in 149.7 million tonnes grading 1.45 g/t Au. Mineral Resources, inclusive of reserves comprises Measured and Indicated Mineral Resources of 10 million ounces grading 1.46 g/t Au and Inferred Mineral Resources of 496,000 ounces grading 1.08 g/t Au. Most, if not all mineralized zones are open either or both along strike and to depth with high expectations that additional zones will be discovered.
Since January 1, 2025, Allied Gold’s exploration, comprising 700 holes totaling 60,496 m of drilling (including sterilization drilling), has focused on targeting oxide gold mineralization with a lesser emphasis on fresh-rock-hosted gold mineralization. Significant amounts of oxide and fresh rock gold mineralization have been intersected at the Tambali, Sekekoto/S12 Trend, FE2 Trend and FE4 zones (see Figure 1 for locations). This ongoing work highlights Allied's commitment to creating long-term value through focused and sustained exploration.
The Sadiola property overlies a regionally distinct part of the Western Malian Gold belt where there are more carbonates attesting to a regionally unique original basin architecture. A strong westward rotation of the Senegal-Mali Shear Zone, at the south end of the property, perhaps enhanced by the early basin architecture also created a low-pressure zone that supported the emplacement of felsic to intermediate intrusions and associated higher heat flow and shear zones. Structurally-hosted gold mineralization occurs in all rock types with a preference to the carbonate-clastic contact and in intrusions. Each of the Sadiola Main, Tambali, Sekekoto, FE2.5 and FE4 Zones lie along a limestone-clastic sediment contact that has been fold-repeated up to seven times across the Sadiola Property. This contact has been the focus of shearing, faulting, local carbonate dissolution and gold-bearing mineralization. Silicification, sulphidation (pyrite, arsenopyrite and stibnite), potassic (biotite) and skarns (Sadiola Main Deposit) are the dominant alteration types. The result is a world class series of gold deposits that will not be fully defined for quite a few years if ever.
The following sections provide additional details for the primary target areas including figures that present context and select drill hole intercepts, greater than 10 g/t Au x metres, from unmined areas. Thus, some hole assay summaries may not contain all drill hole intercepts for that respective hole.
Sadiola Main
The Sadiola Main deposit, including a group of smaller northeast-trending deposits, has been traced for 2,500 m along strike, up to 200 m across strike (Figures 1 and 2), to approximately 800 m depth and remains open at depth. The oxidized portions of the deposit have been mined down to 200 m to 220 m below surface. Mining of the remaining oxide and transition facies mineralization is ongoing. A type section through the middle of the deposit (Figure 3) shows the strong gold grades over good widths along the central part of the zone extending to below the area tested by drilling and numerous, secondary mineralized structures.
Drilling recently resumed testing the Sadiola Main deposit with goals of:
- better defining the numerous mineralized sub-structures within the reserve pit envelope to further reduce waste-to-ore ratios,
- extend oxide gold zones, especially where the northeast-trending Tambali zones would intersect the Sadiola Main deposit, and
- further trace the deposit to the south and at depth, to provide support for extending the Sadiola Pit to the south perhaps eventually linking up the Tambali Pit with the Sadiola pit.
Tambali
The 2,200 m by 500 m Tambali deposit lies approximately 600 m southwest of the Sadiola Main Deposit (see Figure 1). Its western extent is controlled by a graphitic unit which lies at a north-northwest trending, limestone-clastic sediment contact. Multiple corridors of northeast-trending intrusion- to sediment-hosted gold mineralization that extend towards the Sadiola Main open pit may be correlated to the northeast trending zones in the Sadiola Main Pit. The upper, oxide gold mineralization portion of the deposit was mined until 2023 with production of approximately 403,000 ounces of gold(1). Historic drilling indicates that the oxide gold mineralization is open to the north and in local areas within the pit. Over the last couple of years, Allied has carried out several modest drill campaigns to test the fresh rock portions of this deposit with dual goals of defining near surface fresh rock mineral resources which could be processed in the Sadiola mill as needed and testing for additional oxide gold mineralization.
Since January 2025, Allied has completed 44 holes totaling 12,005 m of drilling (Figure 4), dominantly to further define the northeast-trending mineralized structures. Gold-bearing mineralization dominantly occurs in numerous discrete cross-cutting structures and along bedding planes along the entire strike length of the deposit with the deepest intercepts to a maximum of approximately 400 m below surface. It is likely that the mineralized trend continues to the north and to the northeast, towards the Sadiola Main Deposit and is open to depth. Allied drilling has intersected multiple mineralized structures with intercepts to 18.9 m @ 12.6 g/t Au in hole SADD 181 and 31.2 m @ 2.84 g/t Au in SADD138. Mineralization is hosted by felsic and mafic dykes and in the clastic sediments. Modelling of these multiple zones of gold mineralization is ongoing. A type-section of the deposit with select drill intercepts displayed is presented in Figure 5.

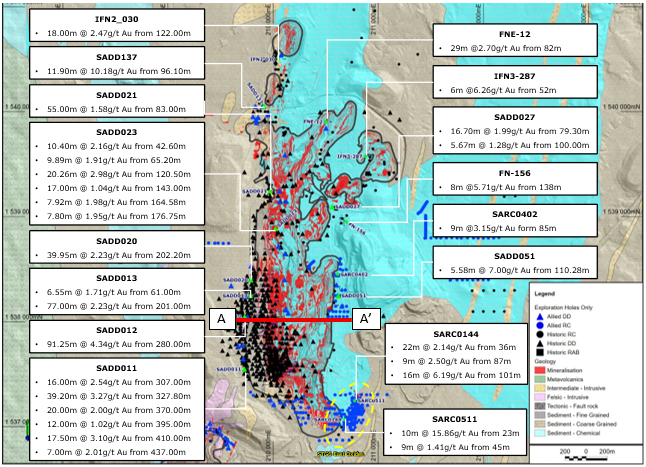

Figure 2: Sadiola Main Deposit Geology and Drill Plan

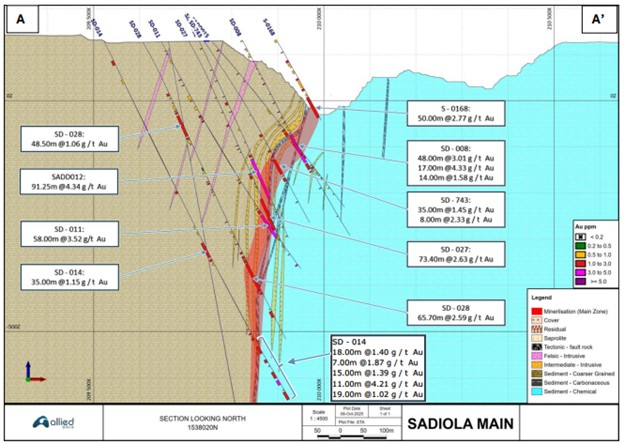

Figure 3: Sadiola Main Deposit Reference Section

Figure 4: Plan view Tambali Geology and Drilling

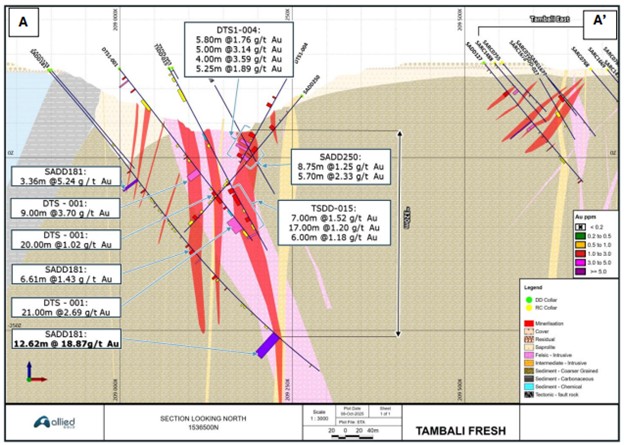

Figure 5: Tambali Type Section

Sekekoto West and S12
Exploration drilling in 2025 comprised 91 holes totaling 9,281 m including a significant amount of closely spaced drilling to support a dominantly oxide resource estimate (Figure 6). Gold mineralization has been intersected in three areas, Sekekoto, S12 and Sekekoto West (most recent discovery).
Sekekoto is a northwest trending gold-bearing structure that lies on the east side of a carbonate unit that produced 41,000 ounces of gold(1). Sekekoto West lies adjacent to the western side of the same carbonate unit. IP resistivity data highlights the carbonate-clastic sediment contact and has provided a good guide for drilling to trace the mineralization along the geological contact to the north.
Sekekoto West is a relatively recent discovery. Oxide and fresh gold mineralization has been traced for approximately 1,400 m along strike and to 80 m depth (the limit of drilling) with a short-term focus on the oxide gold mineralization. Sekekoto West consists of one to two northerly-trending mineralized zones and at least one northeast-trending intersecting structure where drilling returned better-than-average widths and grades (Figure 5). Significant intercepts include 1.82 g/t Au over 30.00 m, 2.57 g/t Au over 8.00 m, 5.19g/t Au over 10.00 m, 11.90 g/t Au over 25 m, and 7.06 g/t Au over 41.00 m. Higher grade zones appear to plunge moderately to the north, however, an overall shallow north plunge has also been inferred. Figure 7 presents a simplified cross-section through the north end of the Sekekoto West Deposit.
The S12 zone lies an additional 650 metres north of the northernmost Sekekoto West drilling. This zone, which lies just east of the tailings pond, has returned numerous significant results to 26.3 m grading 14.59 g/t Au. Modelling of this karst-like deposit will be carried out upon completion of a Q1 2026 resistivity survey to help define the karst open spaces, sand fill and breccias.

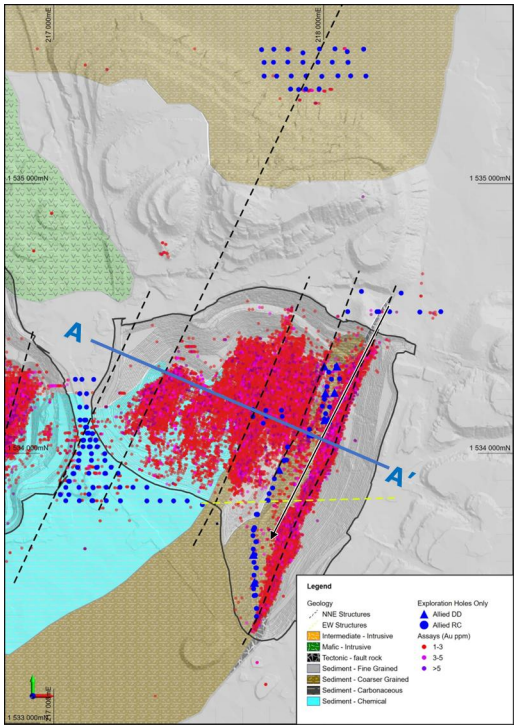

Drilling is advancing at 100 m step-outs to the north as we continue to intersect mineralization with the northernmost hole, with results returning a fresh rock, near-true-width intercept of 8 metres grading 4.03 g/t Au at approximately 70 m below surface. The zone appears to narrow to the south but will be tested further in the future.

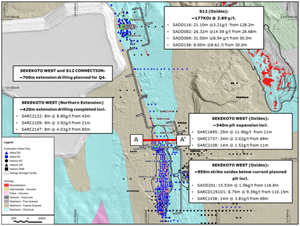

Figure 6: Sekekoto West and Sekekoto Drill Plan and modelled/active pits

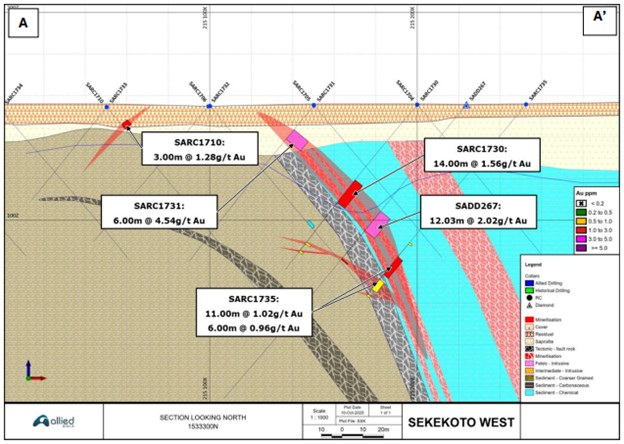

Figure 7: Type Section Sekekoto West Deposit

FE2 Trend
The at least 5,500 m long FE2 Trend also follows a carbonate-clastic contact. It comprises, from south to north, the 1.1 km-long FE2.5 oxide gold prospect, the 1.1 km FE2S zone, the historic 1.2 km long FE2 pit (produced 108,000 ounces(1)) and the FE2N portion for another 500 m to the north of the FE2 pit (Figure 8). Oxide gold mineralization has now been followed, more or less continuously for 3.9 km and remains open to the north. Allied drilling along this trend in 2025 comprised 452 holes totaling 26,378 m of drilling. Only oxide gold mineralization was mined at the FE2 pit with reports that a material amount of oxide gold mineralization remains. As well, drilling below the FE2 pit continued to intersect economic-grade gold mineralization in fresh rock to approximately 140 m depth, beyond this the zone is still open.
The FE2.5 zone has been detailed drilled with potential for a modest-sized oxide gold mineral resource. Notable FE2.5, intercepts include 3.4 g/t Au over 16 m, 1.92 g/t Au over 23 m and 6.55 g/t Au over 8 m. The FE2.5 deposit comprises up to three mineralized lenses plunging approximately 10° to the north and dipping shallow to moderately east. The mineralization has been traced down to a vertical depth of 120 m and remains open to depth. Since completing the FE2.5 drilling, drilling was carried out on the 1.1-km-long portion of the trend (FE2S) between the FE2 pit and FE2.5 resource and north of the FE2 pit. Six short, 100 m spaced RC fences, completed north of the FE2 pit, all returned gold values with better intercepts in both oxidized and fresh rock returning 28.19 g/t Au over 3 m, 6.55 g/t Au over 8 m (Figure 9 cross-section), 4.14 g/t Au over 4 m and 1.84 g/t Au over 6 m. Additional drilling is required to be able to potentially define a mineral resource.

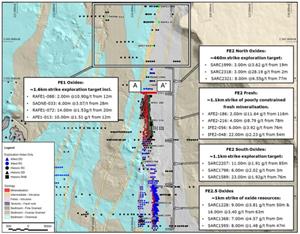

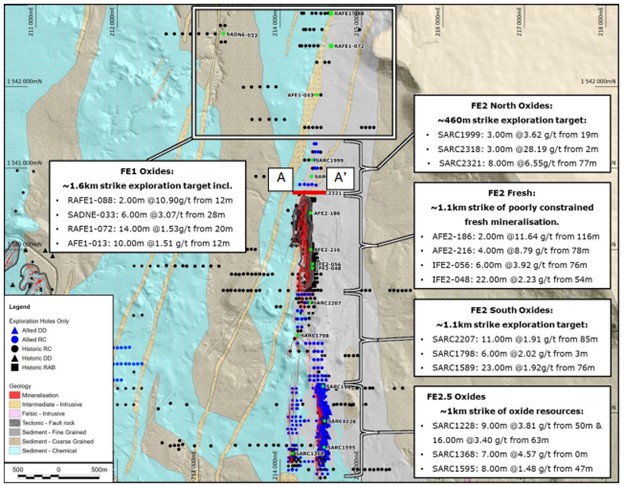

Figure 8: FE2 Trend Geology and Drill Plan

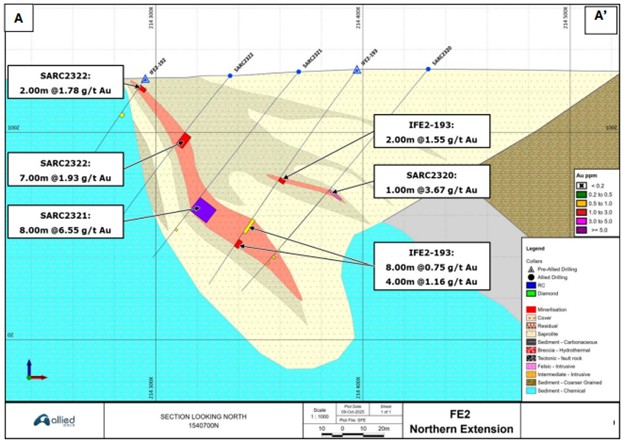

Figure 9: Type section FE2N

FE3/FE4 Trend
Both the FE3 and FE4 pits, which cover an area 3.25 km by up to 1.1 km wide, have been partially mined for their oxide resources (Figure 10) with 1.33 million ounces produced(1). Allied commenced work over these zones in 2021 resulting in partial oxide mineral resource extraction, with ongoing drilling aimed at expanding mineral resources. To date in 2025, 112 holes totaling 12,232 m of drilling have been completed with an average hole depth of 109 m. This drilling focused on converting Inferred Mineral Resources to Indicated Mineral Resources and defining additional oxide resources with occasional holes testing the fresh rock portions at the FE4 pit and along the bridge between the FE4 and FE3 pits. These two deposits lie in an area where northeast-trending fold hinges intersect the carbonate-clastic contact. Higher grades occur in the southeast portion of the historic FE4 pit, in contact with a graphitic shear with recent intercepts to 10.68 g/t Au over 18 m (Figures 11 and 12). Fresh rock and locally oxidized portions of the FE4 pit have been metallurgically challenging with elevated levels of copper and arsenic with drill definition of the fresh rock high-grade zone pending further metallurgical test work.
Exploration is targeting strike extensions of the northeast-trending fold-parallel secondary shears (intercepts to 4.95 g/t Au over 15 metres), the folded interface between the carbonate and clastic rocks in the FE3/FE4 Bridge (Figure 10) and the down-dip extensions of the oxide and fresh gold zones.

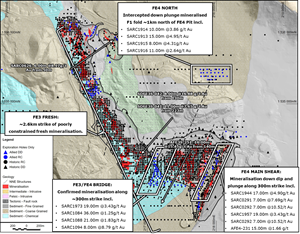

Figure 10: FE3/FE4 Pits, Summary Geology and Drill Plan

Figure 11: FE4 Pit Grade Dot Plot, Allied Drilling and Section Location

Figure 12: Interpreted Geological and Drill Section Through FE4 Pit

END NOTES
(1) Production ounce totals from Sadiola Mine production records
(2) This is a non-GAAP financial performance measure and ratio. Refer to the Non-GAAP Financial Performance Measures section at the end of this news release.
(3) See Allied Gold’s Reserve and Resources statement Allied Gold Corporation - Mineral Reserves and Mineral Resources
Sampling and QA/QC Procedures
All exploration work at Sadiola follows industry-standard sampling, assay, and QA/QC protocols. RC samples are collected at one-metre intervals and split using a 75:25 riffle splitter. Diamond core is cut in half and sampled systematically. Quality control samples (certified reference materials, blanks, and field duplicates) are inserted at a ratio of 1:20.
Most assays are performed externally at Bureau Veritas Bamako (50 g fire assay) and MSA Bamako (photon assay). Allied’s on-site lab analyzes the sterilization hole samples and occasionally supports exploration by processing samples on a dedicated sample preparation line. Laboratories are audited annually and maintain high standards of analytical accuracy. Data management and validation are maintained through the Company’s Fusion database platform.
Qualified Person
All scientific and technical information in this press release has been reviewed and approved by Don Dudek, P.Geo., Chief Exploration Officer, who is a Qualified Person as defined under National Instrument 43-101. Don Dudek has verified the data disclosed in this press release.
